Building a hotel in 2026 is a massive undertaking. The rewards are high, but the capital hurdles are steep. Global hospitality real estate reached $4.91 trillion in 2025. Experts expect this to grow to $5.12 trillion this year. You see the opportunity. You have a vision for a new property. Now you need to know how to get hotel construction loan terms that work for your budget.

Lenders are cautious today. Over $100 billion in commercial mortgage-backed securities (CMBS) loans reach maturity in 2026. This creates a “maturity wall” that makes traditional banks think twice before handing out new cash. You need a strategy to stand out. HotelLoans.Net acts as your guide. We are correspondent and table lenders with 30 years of underwriting experience. We offer 75 different loan options through our network of private investors. We don’t run your hotel, but we make sure you have the money to build it.

Table of Contents

What are the hotel construction loan requirements small business owners face?

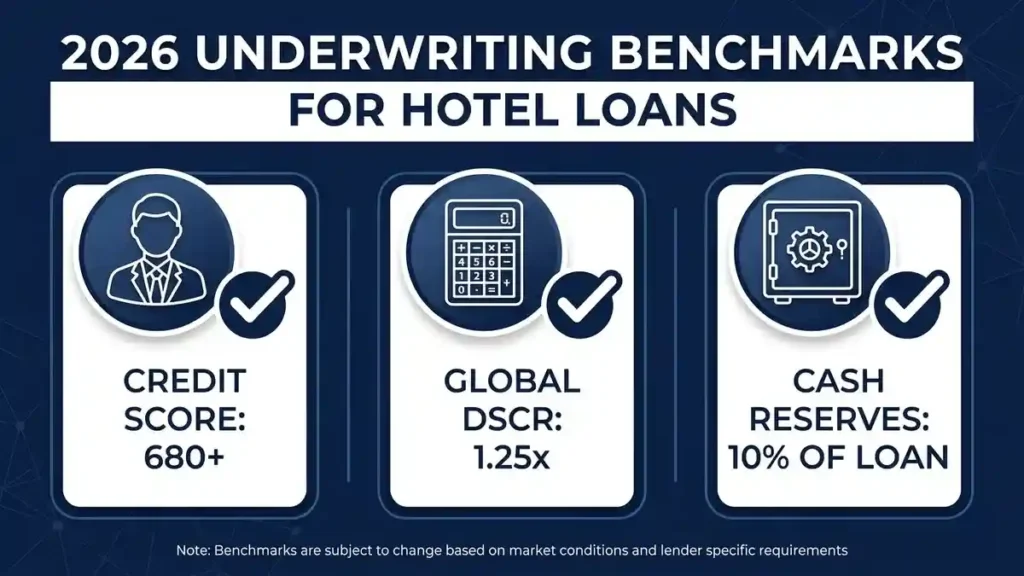

Infographic showing 2026 requirements for hotel construction loans including credit scores and cash reserves.

Small business owners often feel priced out of the hotel market. Lenders look for a “Global Financial Ecosystem” when they review your file. They don’t just look at the hotel. They look at everything you own.

Credit Scores and Personal Guarantees

You need a personal credit score of at least 680. Some lenders require a 720 or higher. If you own 20% or more of the business, you must sign a personal guarantee. This means your personal assets are on the line if the project fails. Lenders want to see that you are an “Owner-Operator.” They prefer sponsors who stay active in the business.

Global Debt Service Coverage Ratio (GDSCR)

Your hotel needs to pay for itself. Lenders use the Debt Service Coverage Ratio (DSCR) to measure this. Most banks require a 1.25x ratio. This means your hotel’s net income must be 25% higher than your loan payments. In 2026, lenders also check your “Global” DSCR. They aggregate the income and debt of every business you own. If your other businesses are struggling, it will hurt your hotel application.

ALSO READ THIS  Construction Loan Brokers: Your Key to Successful Projects

Liquidity and Cash Reserves

Lenders hate “thin” deals. You need “Post-Closing Liquidity”. This is the cash you have left after you pay the down payment. Lenders usually require 10% of the total loan amount in liquid assets. They might also ask for 12 months of principal and interest payments held in reserve. This money protects you during the “ramp-up” period after the hotel opens.

Finding the best lenders for hotel construction financing in 2026

The lending landscape is bifurcated. High-quality assets in big cities get plenty of offers. Small projects in secondary markets have a harder time. You must pick the right partner.

Traditional Commercial Banks

Banks like Bank OZK, M&T Bank, and BMO are active in 2026. They offer the lowest interest rates. They typically fund up to 65% of the construction cost. The catch is their strictness. They often require a pre-existing relationship or a deposit of millions of dollars.

SBA and Government-Backed Options

The Small Business Administration is a powerhouse for hospitality. Lenders like Live Oak Bank specialize in these programs. SBA loans offer lower down payments and longer terms than regular bank loans. They are perfect for projects under $20 million.

Private Debt Funds and Insurance Companies

Private equity and debt funds have filled the gap left by banks. They offer higher leverage, sometimes up to 85%. Firms like Madison Realty Capital and Driftwood Capital are major players this year. Life insurance companies like MetLife and New York Life also fund construction. They prefer “low-risk” deals with high debt yields.

Lender TypeTypical Leverage (LTC)Estimated Rates (2026)
National Banks60% – 65%6.75% – 8.50%
SBA 50480% – 90%5.94% – 7.00%
Private Debt Funds70% – 85%7.50% – 10.50%
CMBS Lenders65% – 75%6.10% – 9.10%

How to qualify for a hotel construction loan with data

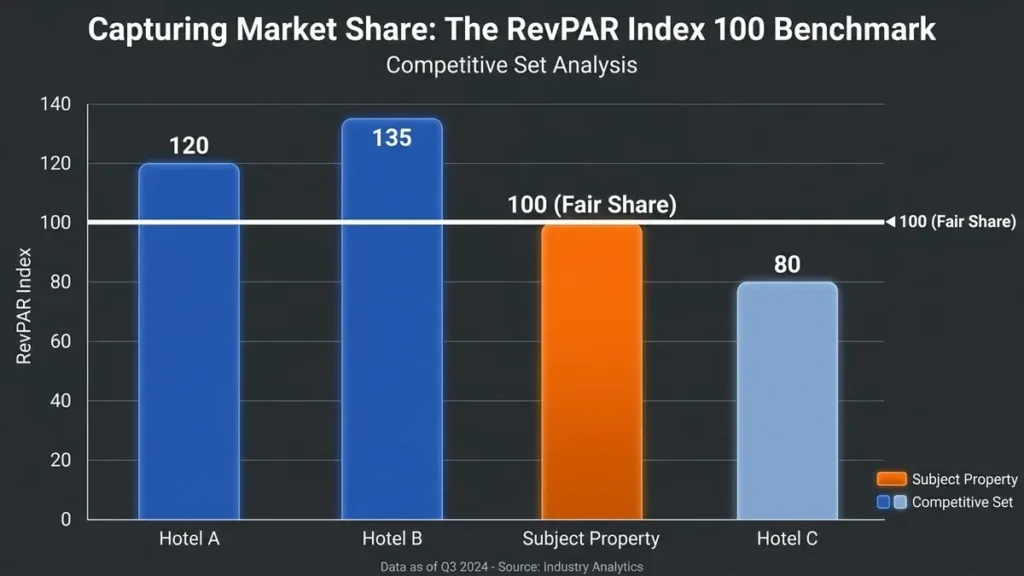

Bar chart showing the RevPAR Index 100 benchmark used to qualify for a hotel construction loan.

You cannot wing it in 2026. Lenders demand institutional-grade data. They want to see that your “Pro Forma” is realistic.

Using STR Reports

Smith Travel Research (STR) data is the gold standard. Lenders use these reports to check your RevPAR (Revenue Per Available Room). They look at your “RevPAR Index”. This measures how your hotel performs against its “CompSet” (competitive set). An index of 100 means you are capturing your fair share of the market. If your projected index is 80, the lender will think your hotel is “tired” or overpriced.

Analyzing ADR and Occupancy

Lenders look for a balance between your Average Daily Rate (ADR) and your occupancy. High occupancy with low ADR means you are leaving money on the table. High ADR with low occupancy means you are vulnerable to seasonal shifts. Oxford Economics expects a 3.9% growth in international inbound travel this year. You must prove your hotel can capture this demand.

Proving Market Feasibility

A formal feasibility study is mandatory for new builds. This study must analyze local demand drivers. Are you near a stadium hosting the 2026 FIFA World Cup? Tourism Economics says host cities will see room revenues jump by 7% to 25% in June 2026. Having this data in your proposal makes you a “sure bet” for the lender.

SBA loans for new hotel construction: 7(a) or 504?

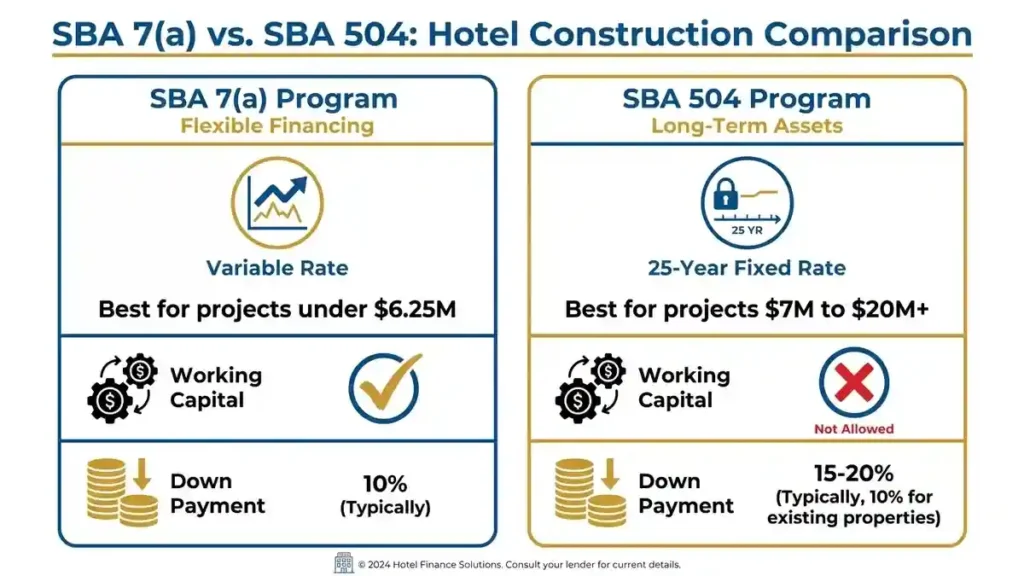

Infographic comparing SBA 7(a) and 504 loan programs for new hotel construction projects.

The SBA offers two main paths for developers. Choosing the wrong one can cost you millions in interest.

The SBA 7(a) Program

The 7(a) is versatile. It is best for acquisitions or small construction projects valued at $6.25 million or less.

  • Pros: It can finance the “full stack.” This includes land, building, and working capital.
  • Cons: It usually has a variable interest rate. If the Prime Rate rises, your monthly payment will rise.
ALSO READ THIS  Hotel Construction Loan Application Tips: A Comprehensive Guide for Developers

The SBA 504 Program

The 504 is the best choice for ground-up construction and large renovations. It uses a “Pari Passu” structure. A private bank provides 50% of the funds. A Certified Development Company (CDC) provides 40%. You provide 10%.

  • Pros: The 40% SBA portion has a fixed rate for 25 years. Rates currently range from 5.94% to 6.05%.
  • Cons: It cannot be used for working capital or marketing.

Hotel renovation loan vs new build loan: Which fits your project?

You might already own a hotel that needs a “Property Improvement Plan” (PIP). Lenders view these differently from new builds.

Financing the PIP Lift

Brands mandate these renovations to keep their “flag”. Lenders focus on the “RevPAR Lift”. This is the revenue jump that results from modernizing the lobby or guest rooms. A successful PIP often lets you raise your ADR by 15-20%.

Adaptive Reuse and Conversions

Turning an old office into a boutique hotel is a huge trend in 2026. These projects need “Construction-to-Permanent” loans. You pay only interest while you renovate. The loan converts to a standard mortgage once you open it. Conversions grew by 3% this year.

Steps to secure hotel development financing fast

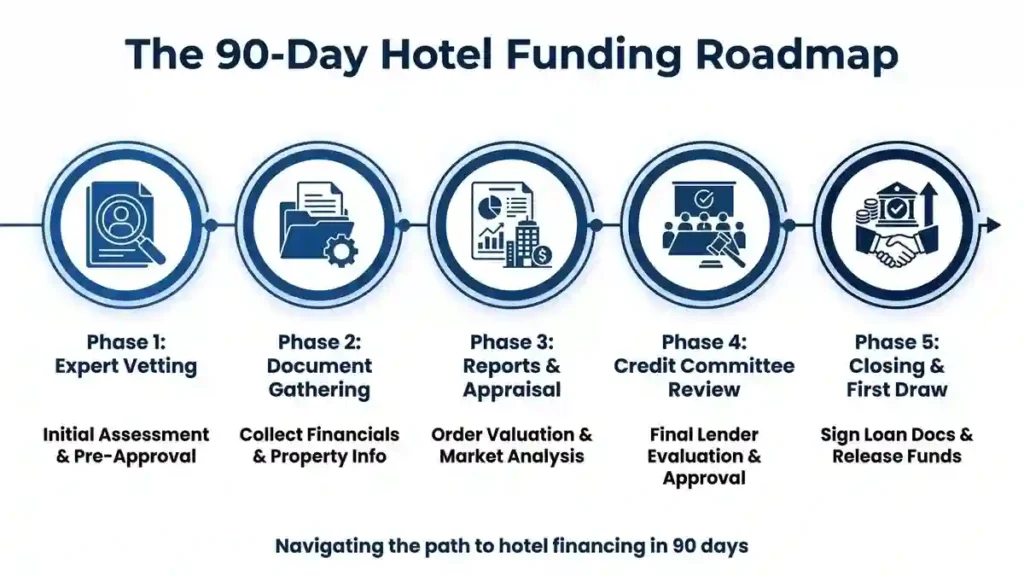

A 90-day roadmap showing the five phases to secure hotel development financing from vetting to closing.

The process takes 60 to 90 days. You need a clear roadmap to avoid delays.

Step 1: Pre-Consultation

Talk to an expert underwriter. We vet your deal before you spend money on reports. We help you pick the right loan from our 75 options.

Step 2: Build the Documentation Fortress

Lenders need a “Firm Fixed-Price” contract from your general contractor. They also need your franchise agreement or “Comfort Letter”. Missing one document can stall your closing for weeks.

Step 3: Order Third-Party Reports

The lender will order an appraisal and a Phase I Environmental Site Assessment (ESA). In 2026, wait times for these reports are longer than usual. Order them early.

Step 4: The Credit Committee

Underwriters present your deal to the bank’s executives. They stress-test your DSCR. They ask: “What if occupancy drops by 20%?” Your feasibility study must answer this.

Step 5: Closing and Draws

Once approved, you close the loan. You don’t get the cash in one lump sum. You receive “draws” as you reach construction milestones, such as finishing the foundation or framing.

What are the average interest rates hotel construction loans carry today?

Rates are in a “higher-for-longer” phase. They are tied to several major indices.

The WSJ Prime Rate

This is the basis for SBA 7(a) and small-business loans. It currently sits at 6.75%. Lenders usually add a spread of 2.75% to 3.00%. This brings your total rate to around 9.50% or higher.

The SOFR Index

The Secured Overnight Funding Rate (SOFR) is for institutional deals. The 30-day SOFR is about 3.65%. Typical spreads are SOFR + 350 to 600 basis points. This results in a floating rate between 7.15% and 10.15%.

U.S. Treasury Yields

These drive the 504 and CMBS fixed rates. The 10-year Treasury is around 4.30%. Fixed rates for 504 loans are competitive, often staying near 6%.

IndexCurrent Value (Apr 2026)Used For
WSJ Prime Rate6.75%SBA 7(a), Bank Loans
30-Day SOFR3.65%Institutional Debt
10-Year Treasury4.30%504 Fixed Rates

Minimum equity required hotel construction loan reality

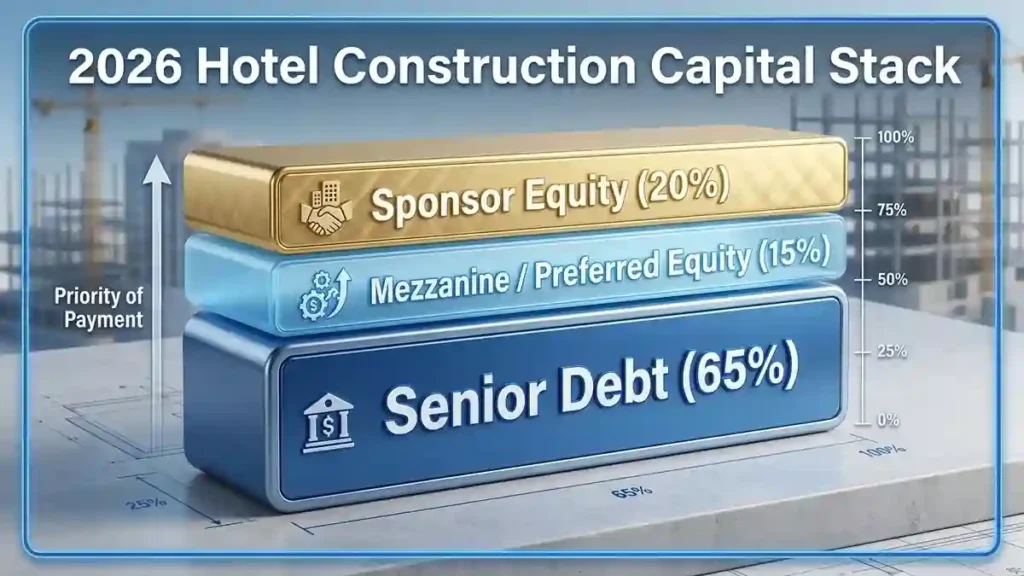

A capital stack diagram showing the layers of debt and equity required for a 2026 hotel construction loan.

Equity is your “skin in the game.” Lenders have increased their requirements to protect themselves from 2026 market volatility.

The 30% Down Standard

Conventional lenders now require 30% to 35% equity. SBA loans are the exception, allowing down payments of 10% to 15%. If you lack the cash, you must find other ways to fill the gap.

Mezzanine Debt and Preferred Equity

Mezzanine debt sits between your bank loan and your cash. It acts as “quasi-equity.” It is expensive, with rates often between 8% and 9%. Preferred equity is another option. A private firm gives you cash in exchange for priority payments from your hotel’s profit.

ALSO READ THIS  Motel Financing - Your Guide to Owning a Successful Motel

Loan-to-Cost (LTC) vs Loan-to-Value (LTV)

Lenders use both numbers. LTC measures the loan against your actual construction bills. LTV is measured against the projected value of the hotel upon completion. In 2026, LTC is capped at 60-70% for most senior loans.

Hotel construction loan application process guide

Avoid these common traps that kill deals in the 2026 credit market.

The “Back of the Napkin” Math Trap

Lenders decline any project that uses “estimates” for construction costs. You need a line-item bid from a reputable contractor. Inflation in steel and labor has made lenders very nervous about floating costs.

The Management Experience Hurdle

If you have never run a hotel, you will be declined. You must hire a “Third-Party Management Company” (3PM) with a track record. Include your General Manager’s resume in your application package.

The Appraisal Surprise

Wait times for appraisals have increased. Some take 45 days. Start this process as soon as you have a signed term sheet.

Franchise hotel construction loan options vs Boutique hotel construction financing tips

Your choice of “brand” determines your loan terms.

The Power of the Flag

Lenders love “flagged” hotels like Marriott, Hilton, or IHG. Branded hotels have built-in reservation systems. This reduces the “Customer Acquisition Cost.” A brand-loyal guest is easier to find than a new one. Lenders require a “Comfort Letter” from the brand before they close the loan.

Tips for Boutique Developers

Boutique hotels are thriving in the “Experiential Economy”. To get a loan, you must prove your location is “irreplaceable”. Your design must be unique. You should include a wellness spa or a Michelin-star restaurant to drive higher ADRs. Expect to put down 5% to 10% more equity for an independent hotel.

Hotel ground-up construction loan requirements

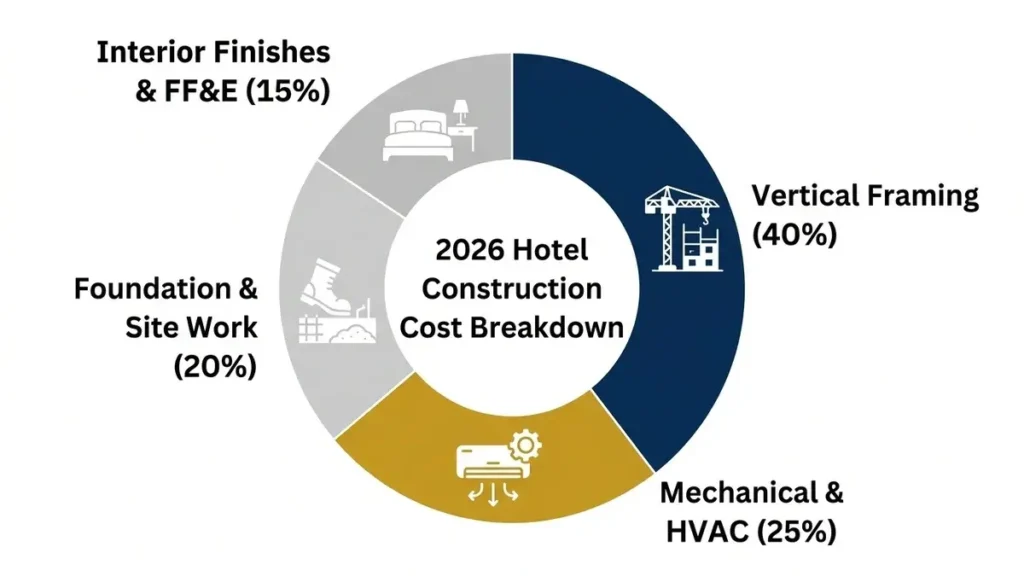

Donut chart showing the budget allocation for a ground-up hotel construction project.

Building from scratch is the most complex path. In 2026, hard construction costs average $250,000 per key.

Technical Budget Breakdown

  • Foundation and Site Work: 15-20% of your budget.
  • Vertical Framing: 30-40%.
  • HVAC and Systems: 20-25%.
  • Furniture and Finishes (FF&E): 15-20%.

Interest Carry and Reserves

Your hotel makes no money during construction. The lender sets aside an “Interest Reserve” within your loan. This reserve pays the monthly interest bills until you open. If your project is delayed, you might run out of reserve cash. This is why we recommend over-capitalizing your project by 10%.

Private equity hotel development financing

For projects over $50 million, you often need private equity partners.

Joint Ventures (JV)

In a JV, a private firm provides most of the cash. They take a large share of the profit. This lets you build a “Trophy Asset” without having all the cash yourself.

Preferred Returns

Private equity firms usually demand a “Preferred Return” of 12% to 15%. They get paid before you see any profit. If the project hits trouble, they often have the right to take over management.

Hotel construction loan for first-time developers

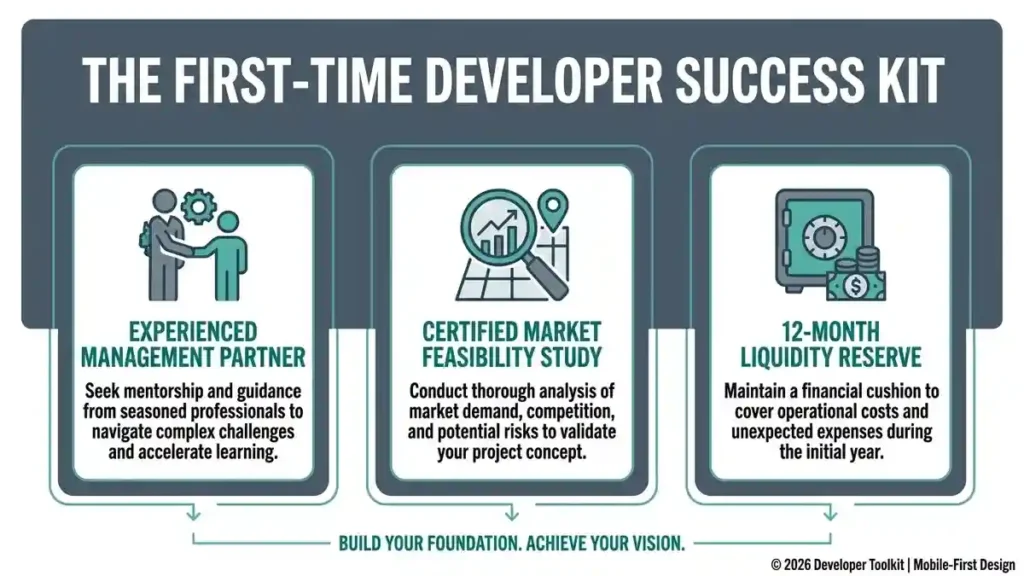

Checklist showing how first-time developers can qualify for a hotel construction loan using management partners and feasibility studies.

You can win even without a track record. You just need the right team.

  1. Hire a “Gun” GM: Provide a resume for a manager with 10+ years of experience.
  2. Buy a Feasibility Study: Get a report from HVS or STR. This gives the lender an “unbiased” reason to say yes.
  3. Use a Super Broker: HotelLoans.Net knows which of our 75 options are friendly to first-time sponsors. We help you package your story for the best results.

Refinancing hotel construction loan after completion

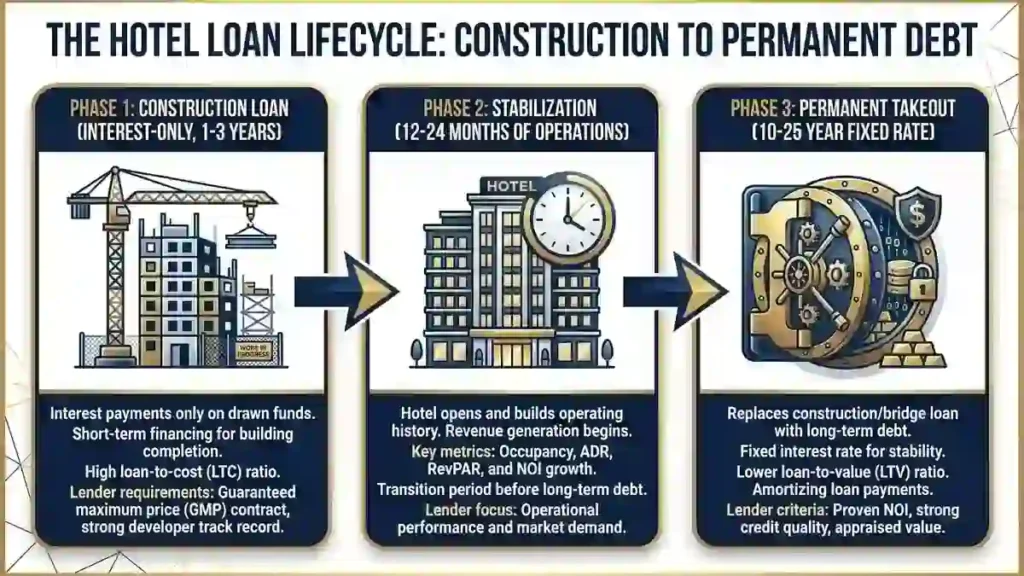

Flow diagram showing the transition from a short-term hotel construction loan to long-term permanent financing.

The construction loan is just a bridge. You must have a “Takeout” plan.

When to Refinance

You refinance once you achieve “Stabilization”. Lenders define this as 12 to 24 months of steady income. Your DSCR must be 1.25x or higher based on your actual financials.

Takeout Options

  • SBA 504 Refinance: Lock in a 25-year fixed rate to get away from high bridge rates.
  • CMBS Loans: Ideal for stabilized hotels. They are “non-recourse,” meaning the lender cannot take your personal house if you default.
  • Bridge-to-Perm: Some of our 75 options automatically convert from construction to a 10-year term loan. This saves you the cost of a second set of closing costs.

Building a hotel in 2026 requires more than just bricks. It requires a data-driven strategy and the right financial partners. HotelLoans.Net is here to find that capital for you. We leverage 30 years of expertise to turn your hospitality vision into a reality. Contact us today to review your project.

FAQs

Can foreign nationals get SBA hotel loans?

No. As of March 2026, the SBA banned non-citizens from these programs. All business owners must be U.S. citizens or nationals. They must also have their primary residence in the United States to qualify for 7(a) or 504 funding.

Can I use land equity as collateral?

Yes. Lenders often allow you to use the current value of the land you own as your down payment. This reduces your cash needs. You must get an appraisal to prove your equity is high enough for the loan terms.

Does modular construction change my financing structure?

Yes. Modular builds require up to 70% of construction costs upfront to buy materials and book factory time. This is different from standard draws. You must find a specialist lender who understands these heavy initial payments and factory-controlled production cycles.

Do I always need Phase II reports?

No. You only need a Phase II report if your Phase I study indicates contamination. These reports involve soil boring and water testing. They are expensive, so only order them if your environmental consultant detects serious issues.

Will lenders hold back construction funds?

Yes. Lenders typically keep a “retainage” of about 10% from every draw. They hold this money until the project is finished. This practice ensures your contractor completes the job to your specifications and pays all subcontractors before the final payment.

Share:

More Posts

Send Us A Message

Ready to Discuss Your Hotel's Financial Strategy? Need a Commercial Loan?

Contact us today at Hotel Loans to initiate a conversation about how our financial expertise can contribute to the success of your hotel business. Our experienced team will be happy to help you.

We're A Member Of

aapl memberemblem hotel loans

BBB Member

Commercial Lending USA BBB Business Review
Scroll to Top
